Data Migration: 7 Steps for a Safe Move in 2026

In short, here’s what you’ll discover in this article: how data migration works, which strategy fits your risk and downtime limits, and how to move information without losing accuracy, security, or business continuity.
What is data migration?
Data migration is the planned transfer of data from one system, storage platform, database, application, or environment to another. The destination may use a different structure, format, or technology. Therefore, migration is rarely as simple as copying files.
A sound project identifies what must move, cleans it, maps source fields to the target model, transforms incompatible values, loads the data, and proves that the result is complete. According to IBM’s overview of data migration, the right method depends on data volume, speed, workload types, security requirements, and available network capacity.
Migration is usually a finite project. Integration, by contrast, keeps systems exchanging data over time. Backup creates a recoverable copy, while synchronization keeps two datasets aligned. Confusing these jobs often produces an incomplete scope and an unsafe cutover.
Why organizations migrate data
Companies migrate data when they replace legacy software, consolidate systems after a merger, adopt a cloud platform, upgrade a database, or introduce a new CRM or ERP. A migration may also place scattered information into a warehouse or lake for analytics and AI.
- Storage migration: moving files or objects to new hardware or cloud storage.
- Database migration: changing database engines, versions, schemas, or hosting environments.
- Application migration: transferring records and relationships into a replacement application.
- Cloud migration: moving data from on-premises infrastructure or between cloud providers.
- Business-process migration: moving connected data, workflows, permissions, and operational rules together.
Whatever the trigger, the business goal matters more than the transfer itself. Success means users can trust and use the information in the target system. A completed copy with broken relationships, wrong permissions, or missing history is still a failed migration.

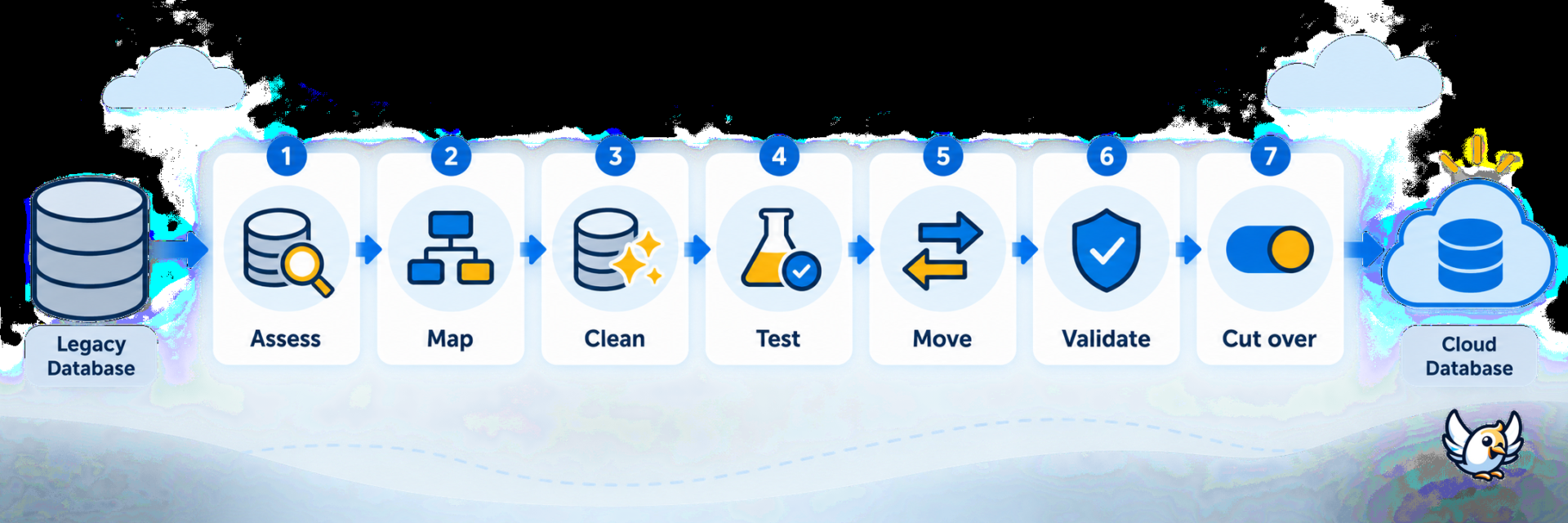

The seven-step data migration process
A reliable data migration follows a controlled sequence. Skipping discovery or validation may make the project look faster, but it moves risk into production.

1. Assess the source and define the outcome
Inventory databases, tables, files, owners, dependencies, retention rules, and consumers. Record baseline counts and quality issues before changing anything. Then define which data is in scope, what can be archived, and what “complete” means for each dataset.
Document downtime limits, compliance duties, target capacity, and recovery objectives. This prevents a technical team from optimizing transfer speed while overlooking the business process that the data supports.
2. Profile and clean the data
Inspect null values, duplicates, obsolete records, invalid dates, inconsistent categories, and unsupported characters. Decide which system owns each conflicting value. Cleaning before loading reduces failures and prevents the new platform from inheriting old problems.
⚠️ Do not delete questionable records silently. Quarantine them, document the rule, and obtain approval from the relevant data owner. A technically valid cleanup can still violate retention or audit requirements.
3. Map source fields to the target model
Create a mapping specification for every object and field. Include source type, target type, transformation, default value, validation rule, owner, and treatment of nulls. Preserve primary keys or maintain a cross-reference table when identifiers change.
Relationships deserve special attention. A customer record may look correct while its orders, notes, attachments, permissions, or consent history point to the wrong entity.
4. Build and test the migration pipeline
Develop repeatable extraction, transformation, and loading logic. Log rejected records and make reruns idempotent, so the same batch does not create duplicates. Protect data in transit and at rest, while limiting access to the migration team.
Run a representative sample in a nonproduction environment. Then complete at least one full-volume rehearsal. Microsoft recommends testing and verifying migration in both system integration testing and user acceptance testing environments where applicable.
5. Execute a dry run
Measure extraction time, transformation time, load speed, validation time, source impact, and rollback duration. Ask business users to test critical workflows, not only individual fields. Reports, search, automations, and downstream exports must also behave correctly.
💡 Treat each rehearsal as a release candidate. Use the same scripts, sequence, access controls, and acceptance checks planned for production. Manual fixes that exist only in a test notebook are not a dependable runbook.
6. Move, synchronize, and cut over
Take a final backup, freeze writes if required, perform the last transfer or synchronization, and route users to the target. Assign one decision-maker the authority to proceed, pause, or roll back. Record every production action and timestamp.
For near-zero downtime, change data capture can replicate ongoing changes after the initial load. However, it adds operational complexity and requires careful monitoring of replication lag and data conflicts.
7. Validate before decommissioning
Reconcile source and target counts, totals, relationships, checksums, rejected rows, permissions, and key business reports. Sample high-risk records and test end-to-end workflows. Keep the legacy environment read-only until acceptance criteria are met and the rollback window closes.
Never use “the import finished” as the acceptance criterion. The project is complete only when the target is accurate, usable, secure, and owned by the operational team.

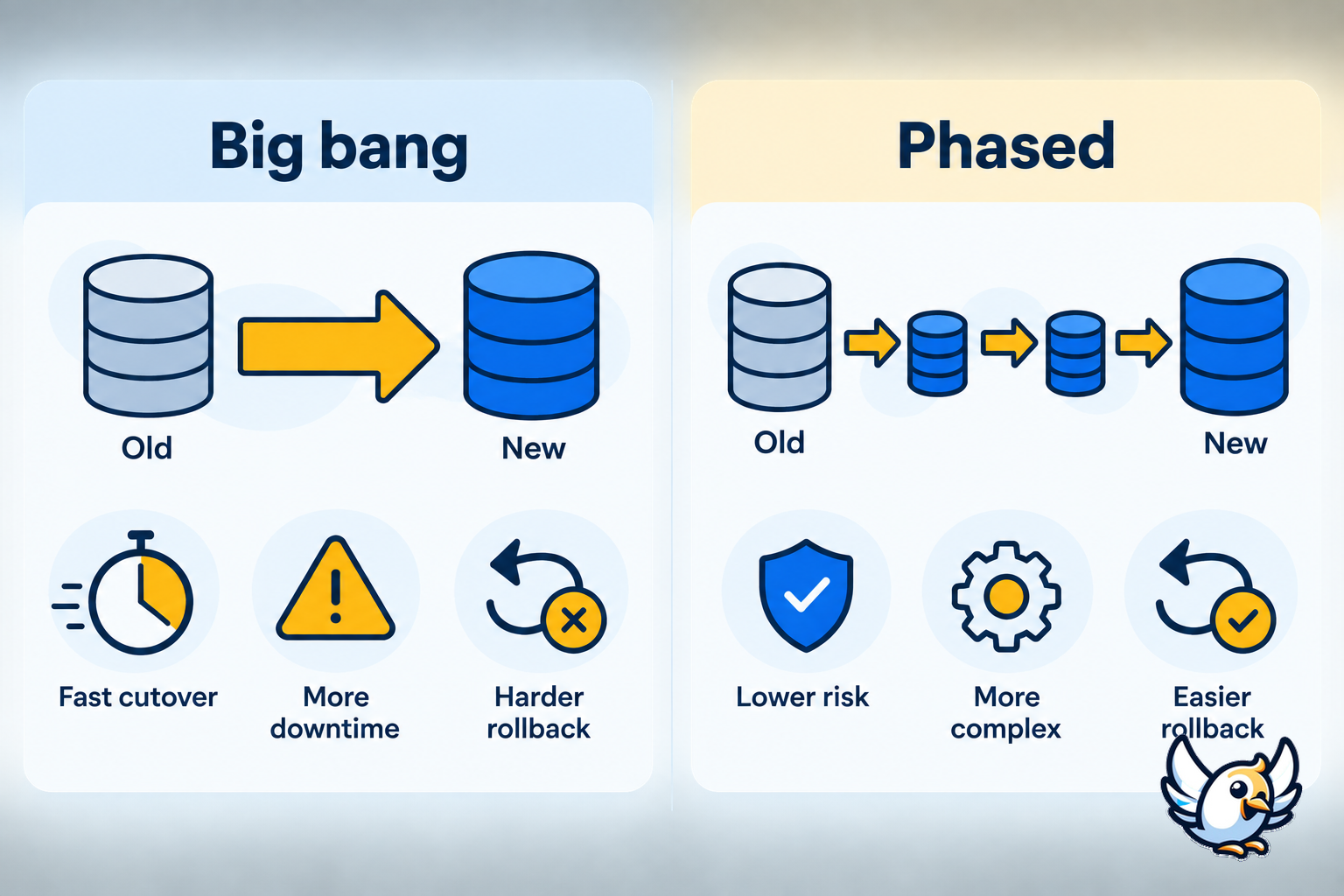

Big-bang or phased migration?
The two main cutover patterns differ in speed, complexity, and reversibility. AWS describes both all-at-once and phased approaches, noting that a phased cutover can reduce impact and simplify rollback for many business-critical workloads.

| Approach | Best suited to | Main advantage | Main risk |
|---|---|---|---|
| Big bang | Small, well-tested datasets with an acceptable outage | Short transition and simpler temporary architecture | Concentrated risk and a demanding rollback |
| Phased | Large or business-critical platforms that can be segmented | Smaller failure domain and gradual learning | Longer coexistence and reconciliation complexity |
| Near-zero downtime | Always-on systems with strict service levels | Minimal interruption through replication | Replication lag, conflicts, and higher engineering effort |
Choose with evidence rather than habit. Consider dependency boundaries, transaction volume, maximum tolerable downtime, rollback time, network throughput, and whether both environments can run safely together.
💡 A phased approach is not automatically safer. If tightly coupled systems cannot be separated, partial migration may introduce inconsistent data. In that case, a carefully rehearsed big-bang cutover can be the clearer option.
How to validate a data migration
Validation should combine technical reconciliation with business acceptance. Record counts alone cannot prove that records are correct or connected properly.
| Control | What it detects | Example acceptance rule |
|---|---|---|
| Record reconciliation | Missing or duplicated rows | Every in-scope source record is loaded or appears in an approved exception log |
| Field validation | Truncation, type errors, or bad transformations | Required fields and allowed values meet target rules |
| Relationship testing | Orphaned child records or broken references | Orders, activities, and files resolve to the correct parent |
| Aggregate comparison | Subtle financial or operational discrepancies | Approved totals match for selected periods and entities |
| User acceptance | Failures in real workflows | Named users complete critical scenarios and sign off |
| Security review | Excess access or missing restrictions | Roles, consent, encryption, and audit logging pass review |
Automate these controls where possible and store the results. This creates an audit trail and makes every rehearsal comparable. It also helps the team distinguish a new defect from an existing source-data issue.
Common data migration risks
Dirty data, undocumented transformations, and weak testing cause more damage than the copy mechanism itself. Other common risks include insufficient bandwidth, unexpected source-system load, encoding errors, permission drift, and downstream integrations that still point to the old environment.
- Back up the source and test that the backup can actually be restored.
- Encrypt transfers and use least-privilege access.
- Keep a complete exception log with owners and deadlines.
- Freeze schema changes during the final migration window.
- Define measurable go/no-go and rollback thresholds in advance.
- Monitor performance, errors, and user reports after launch.
⚠️ A rollback plan must include post-cutover writes. Once users create new transactions in the target, simply switching back can lose those changes. Decide whether you will reverse-replicate, dual-write, restore, or fail forward before launch day.
Does phone data migration include an eSIM?
Not always. A phone-to-phone assistant may transfer photos, contacts, apps, and settings, yet the mobile plan can require a separate carrier transfer or fresh eSIM activation. The exact process depends on the devices, operating systems, carrier, and plan.
Before erasing the old phone, confirm that the new device supports eSIM, that the plan is active, and that mobile data works. If connectivity fails afterward, follow these mobile data troubleshooting steps. Travelers should also understand how data roaming works before enabling it abroad.
Check whether your new phone can use an eSIM before you migrate or reset the old device.
Is your phone eSIM-compatible?
Check the full list of compatible smartphones: iPhone, Samsung, Google Pixel and 200+ models.
Check compatibility💡 Keep the old device available until calls, messages, mobile data, account recovery, and two-factor authentication all work on the replacement.
A practical pre-cutover checklist
- Scope approved: datasets, exclusions, owners, and retention rules are documented.
- Mapping approved: every field and relationship has a target treatment.
- Rehearsal passed: a full-volume run met timing and quality thresholds.
- Backup verified: restoration has been tested, not merely scheduled.
- Access controlled: credentials, encryption, and audit logs are ready.
- Users prepared: support, communications, and acceptance testers are available.
- Rollback defined: triggers, owner, sequence, and post-cutover data handling are clear.
- Monitoring active: dashboards and alerts cover errors, lag, performance, and rejected records.
When every item has an owner and an objective pass condition, the cutover becomes a controlled decision instead of a hopeful deadline.
FAQ
What is the difference between data migration and data integration?
Data migration moves a defined dataset to a target environment as a finite project. Data integration continuously exchanges or combines information between systems. A migration may temporarily use integration or replication technology, but its purpose and end state remain different.
What are the main stages of data migration?
The core stages are assessment, data profiling, mapping, cleaning, pipeline development, testing, transfer, cutover, and validation. Large programs often repeat these stages by workload or business unit.
How do you prevent data loss during migration?
Start with a restorable backup, use repeatable pipelines, reconcile source and target data, log every exception, and rehearse the complete process. Keep the source available until acceptance checks pass and define how post-cutover writes will be protected during rollback.
How long does a data migration take?
Duration depends on volume, complexity, quality, bandwidth, transformation rules, downtime limits, and testing. A small clean dataset may move quickly, while a regulated platform with many dependencies can require multiple rehearsals and a phased program.
What is the safest data migration strategy?
There is no universal safest strategy. Phased migration usually limits the failure domain and improves rollback flexibility. However, tightly coupled systems may be safer in one thoroughly tested cutover. The best choice follows business continuity, consistency, and recovery requirements.
